中国安全科学学报 ›› 2022, Vol. 32 ›› Issue (S1): 103-107.doi: 10.16265/j.cnki.issn1003-3033.2022.S1.0143

• 安全工程技术 • 上一篇    下一篇

人影工程飞机建设项目运维风险与防范

翟薇1(), 马金玉1, 顾青峰1,**(), 李宏宇2

  1. 1 中国气象局 气象发展与规划院, 北京 100081
    2 中国气象局 人工影响天气中心, 北京 100081
  • 收稿日期:2022-01-12 修回日期:2022-04-15 出版日期:2022-06-30 发布日期:2022-12-30
  • 通讯作者: 顾青峰
  • 作者简介:

    翟 薇 (1981—),辽宁丹东人,硕士,高级工程师,主要从事气象工程咨询及项目系统设计等方面的工作。E-mail:

    马金玉 高级工程师

    李宏宇 正高级工程师

Operational risks and prevention of weather modification aircraft construction projects

ZHAI Wei1(), MA Jinyu1, GU Qingfeng1,**(), LI Hongyu2

  1. 1 Institute for Development and Programme Design, China Meteorological Administration, Beijing 100081, China
    2 Weather Modification Center, China Meteorological Administration, Beijing 100081, China
  • Received:2022-01-12 Revised:2022-04-15 Online:2022-06-30 Published:2022-12-30
  • Contact: GU Qingfeng

摘要:

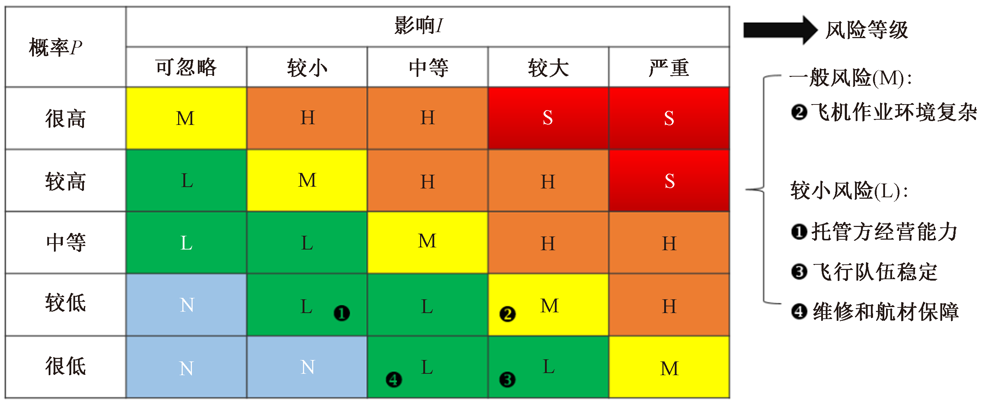

为保障人工影响天气工程(简称人影工程)飞机建设项目的安全实施和稳定运行,提升人影工程项目管理水平,运用风险概率矩阵法进行人影工程飞机建设项目风险分析。首先从工程项目建设角度进行人影工程飞机建设项目风险分类,然后针对运维类风险开展风险分析和评价,最后提出飞机托管方经营能力、飞机作业环境、飞行队伍、维修和航材保障4方面运维风险的具体防范措施。结果表明:飞机托管方管理水平和资源调配能力是影响飞机建设项目运维风险的主要因素,必须加强人影工程全生命周期内飞机托管方的科学比选和监督管理。

关键词: 人影工程, 飞机建设项目, 运维风险, 风险防范措施, 风险概率矩阵

Abstract:

In order to ensure safe and stable aircraft construction in weather modification projects, and improve project management, risk analysis was carried out by using risk probability matrix method. Firstly, risks were classfied from a perspective of project construction, and then, analysis and evaluation of operational and maintenance risks was carried out. Finally, concrete preventive measures were proposed from aspects of operational capability of aircraft management companies, operating environment, flight crew, and maintenance and air material support. The results show that the management and resource allocation ability of aircraft management companies are the main risk factors. It is necessary to strengthen scientific selection, and their supervision and management in the whole life cycle of projects.

Key words: weather modification project, aircraft construction program, operational risk, risk prevention measure, risk probability matrix
